Project : Lim Kwee Jin
Location: No. 3, Lorong Jarak Kanan.






Name(Desc)

Contact

Name(Desc)

Contact

Name(Desc)

Contact

Tony

016-2940 454

Tom Yeap (Windows)

019-6890 773

Amin (AMC Builder)

019-2888 839

Mak

016-5518 511

Dak (Electric)

012-4620 515

Asan (AMC Builder)

017-2577 275

Aaron (PLATO)

016-9211 636

Cheong (Plumbing)

012-2333 363

Najib (AMC Builder)

016-3080 425

Tom (PLATO)

017-2907 102

RAM (Cleaning)

016-6600 974

Alam Jadi (Dustbin)

012-3865 556

Jason

012-2291 021

Dak (CCTV)

012-2163 391

 Edmond (Steel)

012-9759 936





 Ah Kit (Air-Cond)

 012-3783 332

 Ateh (Drainage)

 016-6951 259



Site Report




2012/12/31 (Mon):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)
3) To build a concrete slab to widen the gate entrance.
4) Need to clean up the front drainage frequently.

1)Weather:
3.30pm- 4.30pm raining


2)Daily Tasks:
- Sand arrived - 1 load
- Corner bead arrived - 20pkt
- Kapur arrived 4.30pm - 100pkt
- Tom took 1 set pool mosaic for sample
- Tony and Mak came to visit site

3)Order Material:
- Blue plastic to cover plaster.


4)Feedback/problem:
-
Drainage Ateh didn't come to work, said need to arrange tools transfer from OUG.
- Mak called Dak to complaint the socket installed is not correctly leveled.
- Mak asked to clean up some wood piece in a plastered wall (1st floor), Jason has inform Hassan about it.
- Mak instruct to make sure the sand area is clean to avoid rubbish mixed with sand. Jason has asked Hanif to
  clean it up.

5)Work progress (as at 6pm):
-




2012/12/29 (Sat):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)


1)Weather:
No rain


2)Daily Tasks:
- Sand arrived 12.30pm - 1 load


3)Order Material:
- NIL


4)Feedback/problem:
- Drainage Ateh cannot make it today to start work, he personally informed Aaron.
- Master bedroom toilet leanter did wrong. Has inform Hassan to redo.

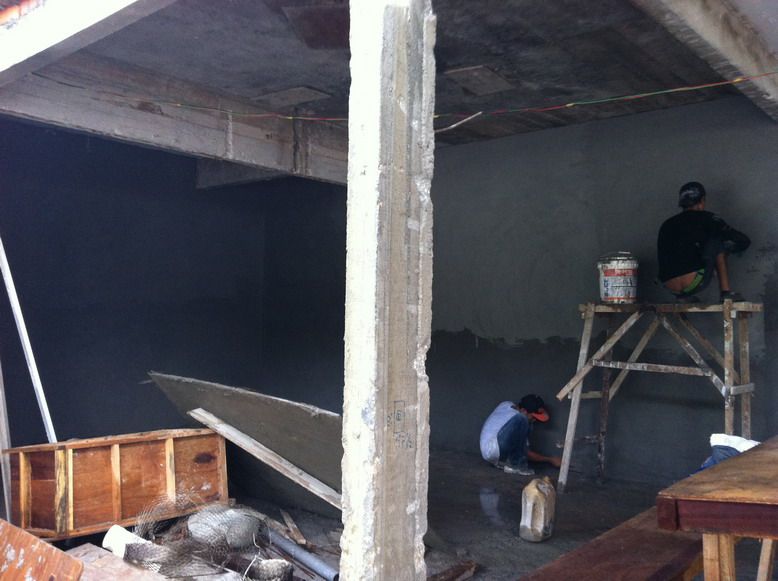

********photo************


5)Work progress (as at 4pm):
-




2012/12/28 (Fri):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)


1)Weather:
No rain


2)Daily Tasks:
- L
ay brick workers help install corner bead to speed up plastering job.
- Aircond job almost done, remaining need to wait for plumbing job to finish the water piping.

3)Order Material:
- Sand 1 load
- Corner bead - 20pkt

4)Feedback/problem:
-
Electrical work could not complete in time, expected done by 15 Jan


5)Work progress (as at 6pm):
-




2012/12/27 (Thu):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)
3) Electrical work start 10 Dec, expected finished by 28 Dec


1)Weather:
No rain


2)Daily Tasks:
*** Aaron give Jason RM1000 (cheque CIMB 000120) as petty cash.

- Ateh (drain) came, asking us to dig for the drainage, will start to work Saturday (29/12)
- Remind Mak again to order Walcrete, coz stock is running low.
- Sand arrived 10.30am - 1 load
- Hassan adding 2 workers to speed up plastering job.
- Hassan instruct lay brick workers to help install corner bead to speed up plastering job.

3)Order Material:
- Walcrete (reminder)
- Sand brick for drain


4)Feedback/problem:
- NIL


5)Work progress (as at 6pm):
-




2012/12/26 (Wed):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec


1)Weather:
No rain


2)Daily Tasks:
- Steel structure start work.
- Call Ateh (drain) to meet tmr (27/12) to discuss 2nd phase drainage work.
- Lightweight brick arrived - 12pm


3)Order Material:
- NIL


4)Feedback/problem:
- Steel structure contractor want to work late till 8pm, but we couldn't allowed.
  Tom suggest they can do job without noise, till 7.30 but their car must park inside after 6pm.
- Aircond not working today but Ah Kit promised will finished job by this week.

5)Work progress (as at 6pm):
-




2012/12/25 (Tue):  Christmas Off

Follow up:
1)


1)Weather:
pm- pm raining


2)Daily Tasks:
-


3)Order Material:
-


4)Feedback/problem:
-


5)Work progress (as at 6pm):
-




2012/12/24 (Mon):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging on 04/01 (Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Need to add one concrete pole at 2nd floor.


1)Weather:
1.30pm- 3pm raining


2)Daily Tasks:
- Jason call Mak to send a hacking machine for workers to hack some area as instruct by Tom.


3)Order Material:
- Sand - 1load
- Walcrete - 400pkt


4)Feedback/problem:
-
Plumbing work has decided to change contractor, expected finished by 21 Jan
- Sam inform steel structure work can only start 26 Dec, expected finished by 15 Jan

5)Work progress (as at 6pm):
-




2012/12/21 (Fri) & 22 (Sat): (Jason OFF)

Follow up:
1)


1)Weather:
pm- pm raining


2)Daily Tasks:
-


3)Order Material:
-


4)Feedback/problem:
-


5)Work progress (as at 6pm):
-




2012/12/20 (Thu):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
2.30pm- 3.15pm raining


2)Daily Tasks:
- Steel structure material arrived 3.30pm. Finished unload 5pm


3)Order Material:
- NIL


4)Feedback/problem:
- Driver that deliver steel material said the supplier should arrange crane to unload.
   Instead, they arrange 4 manpower to unload.


5)Work progress (as at 6pm):
-




2012/12/19 (Wed):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
9pm- 6pm no rain


2)Daily Tasks:
- Alam Jadi 3.30pm collect back their final dustbin. Paid cash, no more outstanding payment.
- Order lorry to transfer wood to No. 17 on 20/12


3)Order Material:
- Order dustbin


4)Feedback/problem:
- NIL


5)Work progress (as at 6pm):
-




2012/12/18 (Tue):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
5pm raining


2)Daily Tasks:
- Red bricks arrived 2pm & 4.30pm
- Sam (steel) came 1.30pm to visit site
- Called Tom Yeap to come & do measuring for sub-frame


3)Order Material:
- NIL


4)Feedback/problem:
- NIL


5)Work progress (as at 6pm):
-




2012/12/17 (Mon):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work has rescheduled, expected start 2nd Jan, finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
3pm- 3.30pm; 5pm raining


2)Daily Tasks:
- Lorry arrived 10am, leave 4.30pm
- Tractor arrived 10am, leave 1.30pm
- Transfer used wood to No 17.


3)Order Material:
- Red-bricks (6 pallet)


4)Feedback/problem:
- DBKL officer come again to check cleanliness & mosquito issue.
   This time nothing's wrong, but he still asked for money.
   Tom paid RM100 to him.


5)Work progress (as at 6pm):
-





2012/12/15 (Sat):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
9am- 10am raining


2)Daily Tasks:
- Hassan buy 2pkt adhesive cement for lightweight brick wall - RM30
- Hacking job instruct by Tom


3)Order Material:
- NIL


4)Feedback/problem:
- NIL


5)Work progress (as at 6pm):
- Swimming pool



***********************************


2012/12/14 (Fri):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 20 Dec, expected finished by 15 Jan
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
3pm- 4pm raining


2)Daily Tasks:
*** Aaron gave RM500 petty cash to Jason
- 10.30am send workers to clean up No. 17
- 10.45am plumbing comes to work
- 1pm Mr Lee (swimming pool) comes visit site
- Sand arrived 2.30pm - 1 load
- Kapur (100pkt) & 3-in-1premixed cement (10pkt) arrived 3.45pm


3)Order Material:
- NIL


4)Feedback/problem:
- Mr Sam said steel structure work can only start 20/12. Jason has informed Tom.


5)Work progress (as at 6pm):
- Ground floor plaster



- 1st floor brick-wall



- Ground floor electrical


- No. 17 cleanup



***************************************


2012/12/13 (Thu):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
4) Electrical work start 10 Dec, expected finished by 28 Dec
5) Steel structure work start 13 Dec, expected finished by 30 Dec
6) Plumbing work expected finished by 28 Dec
7) Need to add one concrete pole at 2nd floor.


1)Weather:
4pm- 6pm raining


2)Daily Tasks:
- Electrical (Dak) staffs came to work 8am

- Aircong staffs came to work 10.45am
- Red-brick arrived 10am - 4pallet (1 more pallet to be delivered later)
- Y10 steel arrived 1pm

3)Order Material:
- 3-in-1 cement - 10pkt
- Kapur - 100pkt
- Y10 steel - 20pcs


4)Feedback/problem:
- Dak (CCTV) not coming to work as scheduled, due to changed of order. Will come next Mon or Tue.


5)Work progress (as at 6pm):
- Ground floor electrical



- Ground floor air-cond


- Ground floor plaster


- 1st floor brick-wall


- 2nd floor open concrete-slab wood



*****************************************


2012/12/12 (Wed):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) Mak ask Jason to get No.17 key from Aaron, then send workers to clean up for putting used wood.
4) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
5) Electrical work start 10 Dec, expected finished by 28 Dec
6) Steel structure work start 13 Dec, expected finished by 30 Dec
7) Plumbing work expected finished by 28 Dec
8) Need to add one concrete pole at 2nd floor.


1)Weather:
2pm- 4pm raining


2)Daily Tasks:
- Jason visit to No.17 Jalan D'sara Endah. Planning for cleaning work



3)Order Material:
- Ordered sand - 1 load


4)Feedback/problem:
- Mak informed red-bricks cannot be delivered today, due to supplier delivery problem.
  Jason suggest to order at least 2 pallet with alternate supplier.
- Water plumbing workers not working today. Jason call the supervisor (Ah Sun), he said busy some other places.
  Jason reported to Tom due to worried of delays of plumbing work. Tom consider change to other contractor.


5)Work progress (as at 6pm):
- First floor brick-wall


- Ground floor plaster




- Ground floor plaster
****************************************


2012/12/11 (Tue):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) Mak ask Jason to get No.17 key from Aaron, then send workers to clean up for putting used wood.
4) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
5) Electrical work start 10 Dec, expected finished by 28 Dec
6) Steel structure work start 13 Dec, expected finished by 30 Dec
7) Plumbing work expected finished by 28 Dec
8) Need to add one concrete pole at 2nd floor.


1)Weather:
1pm- 3pm; 4pm-6pm raining


2)Daily Tasks:
- Sand arrived 10am - 1 load
- En Fahmi came 10.30am to check on the "honey-comb" beam. He will feed back to his boss for further action.
  (refer to 26/11 report)
- Aircond Ah Kit & staff come to work 10.45am
- Plumbing Ah Sun & staff come to work 12.45pm
- Windows Tom Yeap
& staff come to install sub-frame 3pm


3)Order Material:
- NIL


4)Feedback/problem:
- Amin advised that, 1st floor lightweight brick structure might be too heavy. Tom has discuss with Amin to get a
  solution.




5)Work progress (as at 6pm):
- Swimming pool


- Plumbing (manhole)


- Ground floor plaster


- Aircond piping


- Sub-frame



******************************************


2012/12/10 (Mon):

Follow up:
1) To put an extra tube (2-3") from Guard House to the bungalow.
2) NLC Pest Control will do fogging 21/12 & 04/01 (both Friday, 9-10am)
3) Mak ask Jason to get No.17 key from Aaron, then send workers to clean up for putting used wood.
4) 2nd phase drainage work start 17 Dec, expected finished by 10 Jan
5) Electrical work start 10 Dec, expected finished by 28 Dec
6) Steel structure work start 13 Dec, expected finished by 30 Dec
7) Plumbing work expected finished by 28 Dec
8) Need to add one concrete pole at 2nd floor.


1)Weather:
9am-6pm no raining


2)Daily Tasks:
- Dustbin arrived 2pm
